Search address: |
Background and Map of Flood Control Project Features
2020 Deep Tunnel Inspection & Mississippi River Drawdown
Stakeholder Reconvening Meeting, September 27, 2023
Presentations:
Initial Stakeholder Summit, March 29, 2023
Presentations:
Floodplain & Stormwater Management Study, December 2019: Study fact sheet | Full study document
Jevne Park Stormwater Improvement Project
Construction Year: On Hold
Crane Lake Chloride Reduction Demonstration Project
Construction year: 2025/2026
Crane Lake Improvement Project
Construction Year : 2020
Anticipated Construction Year: 2025
Anticipated Construction Year: 2024
Anticipated Construction Year: 2021
Construction Year: 2021
Construction Year: 2018
Construction Year: 2010-2011
Construction Year: 2020
Sochacki Park Water Quality Improvement Project
Anticipated Construction Year: 2024

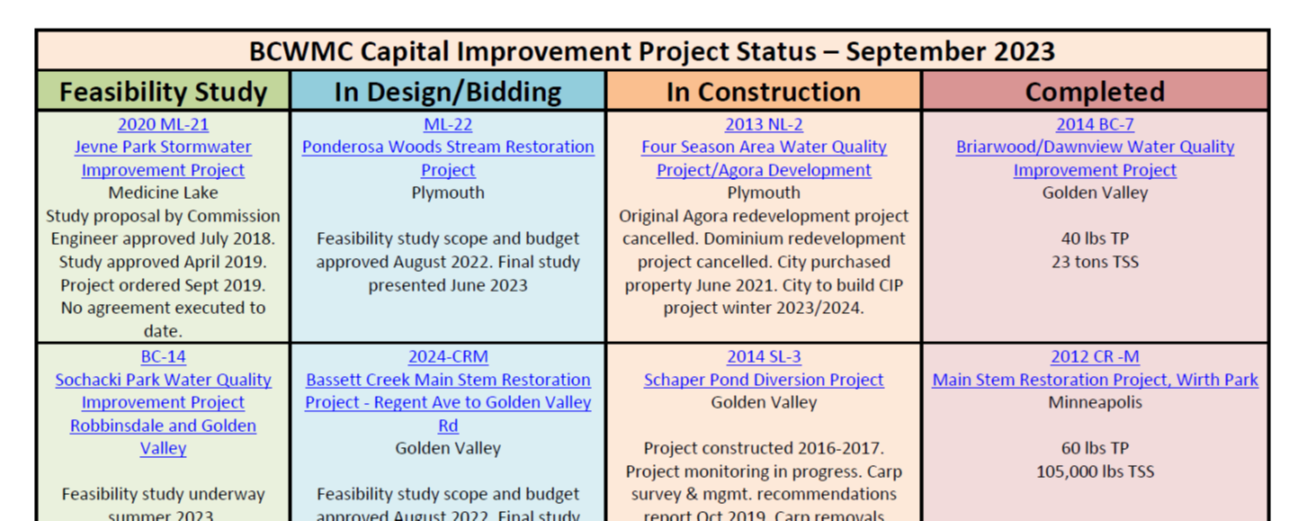

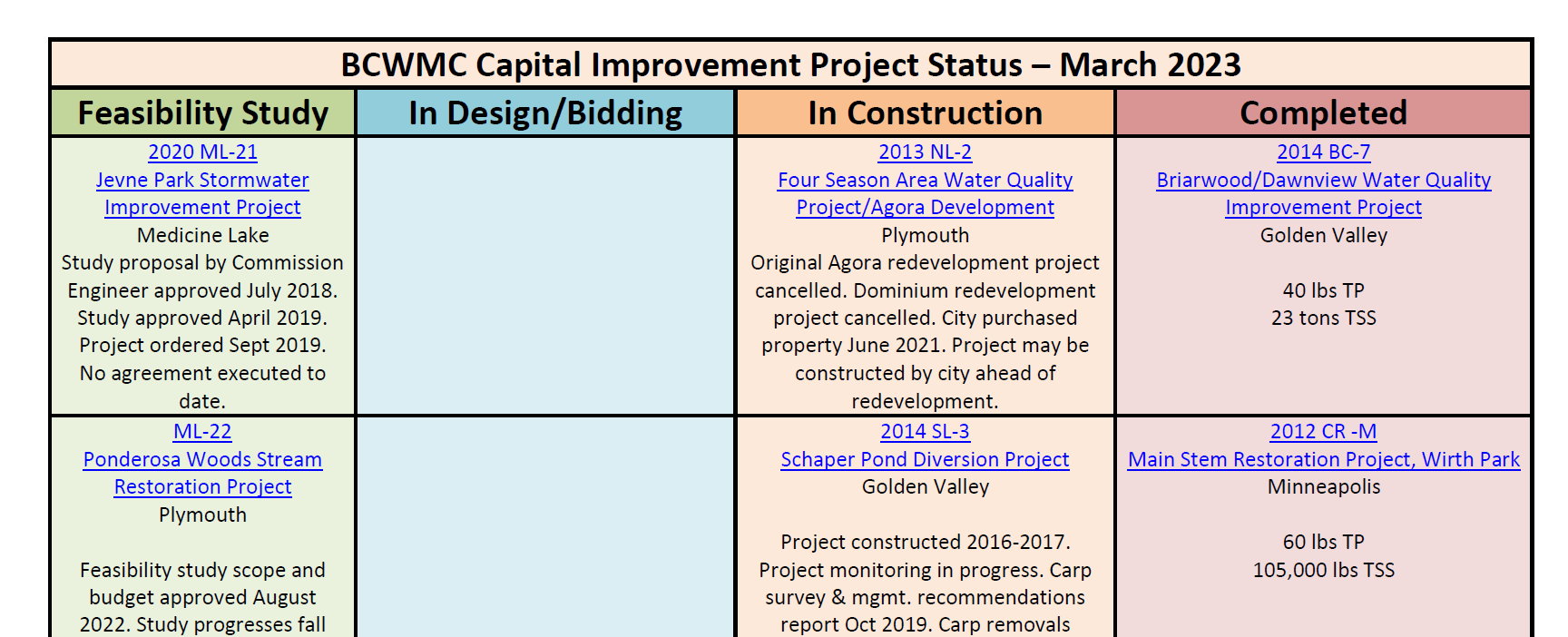

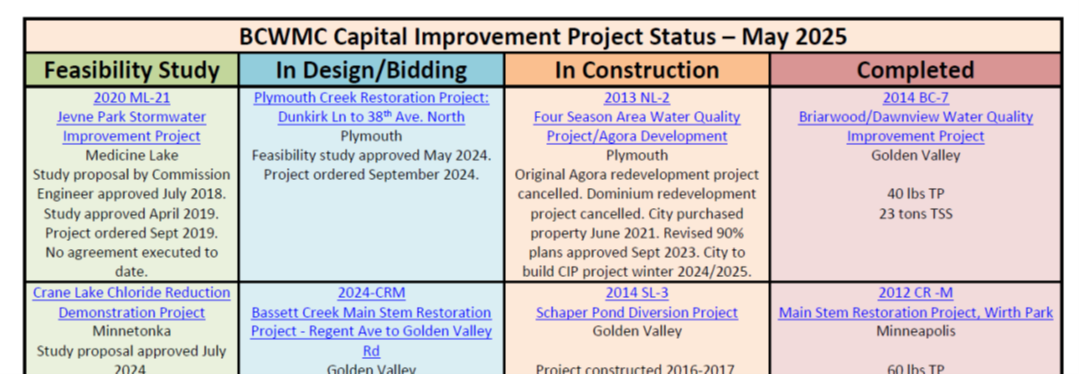

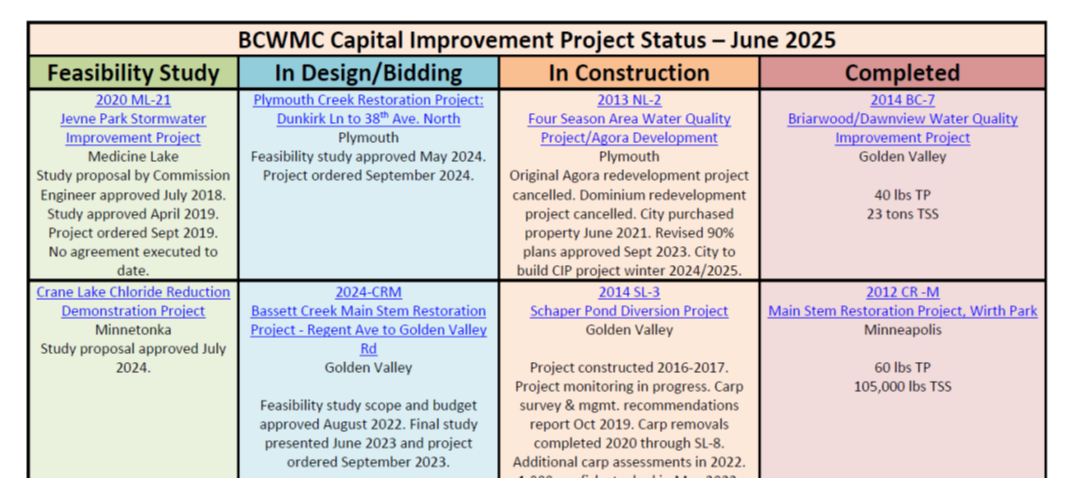

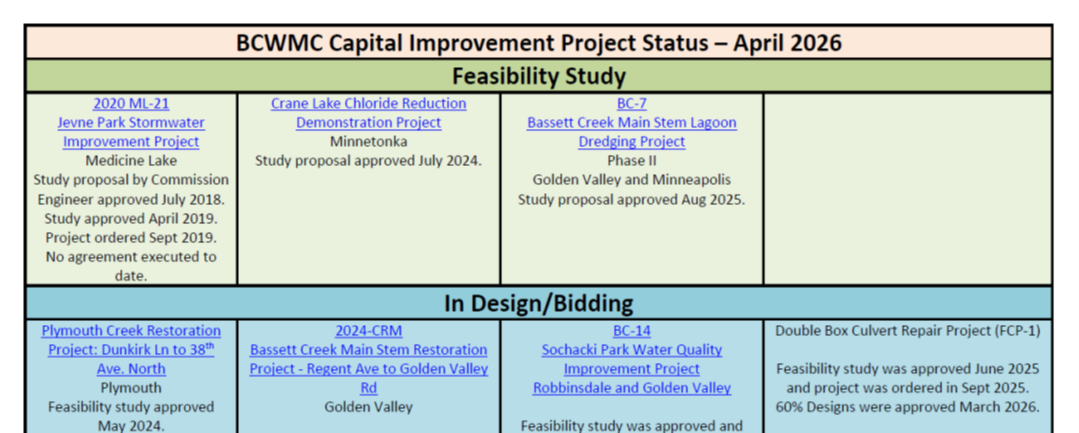

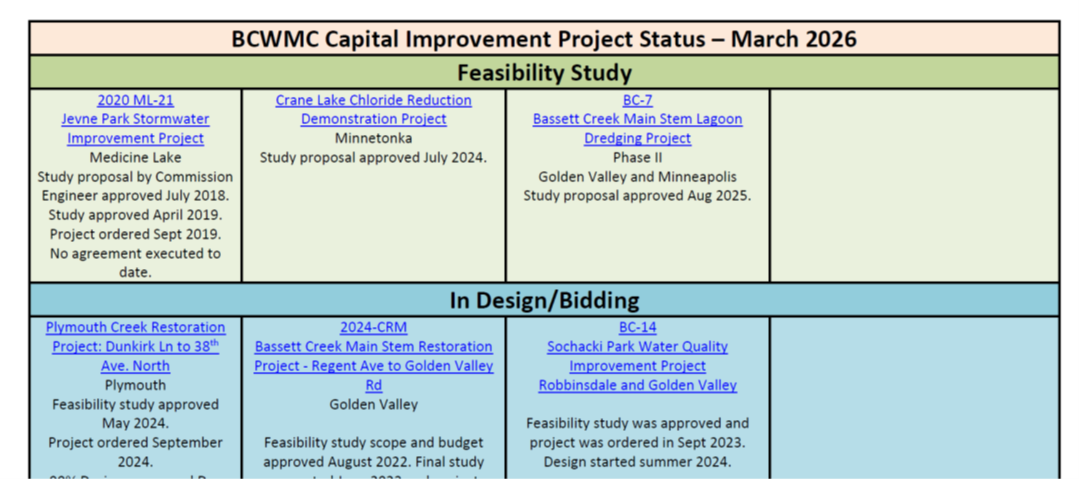

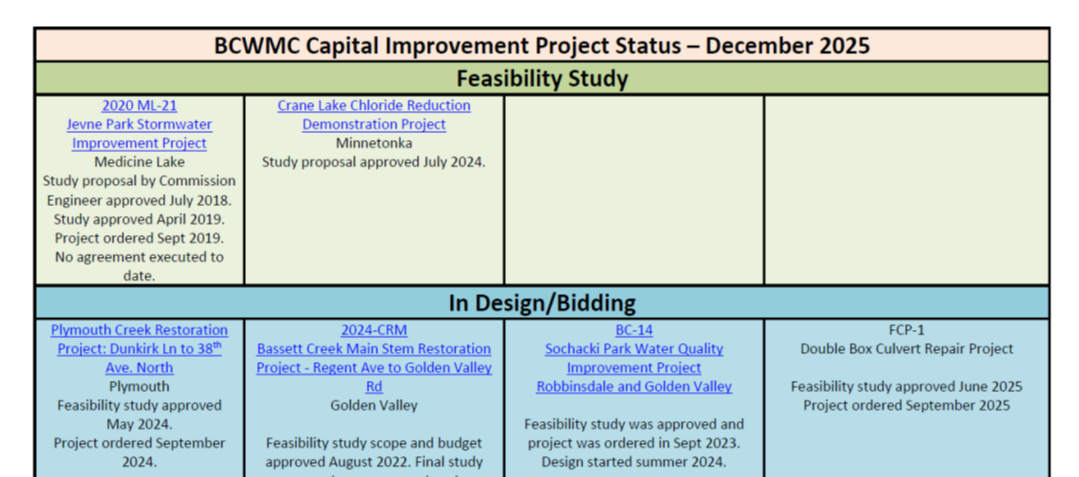

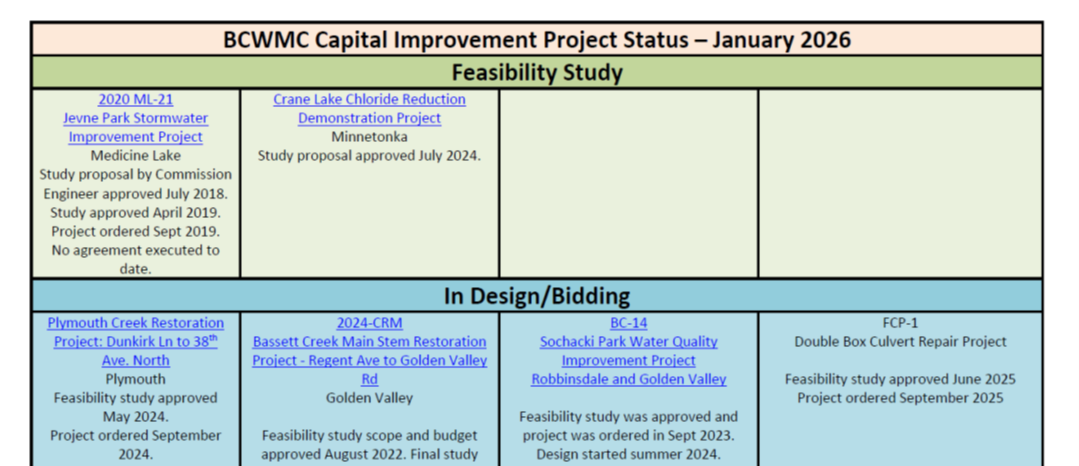

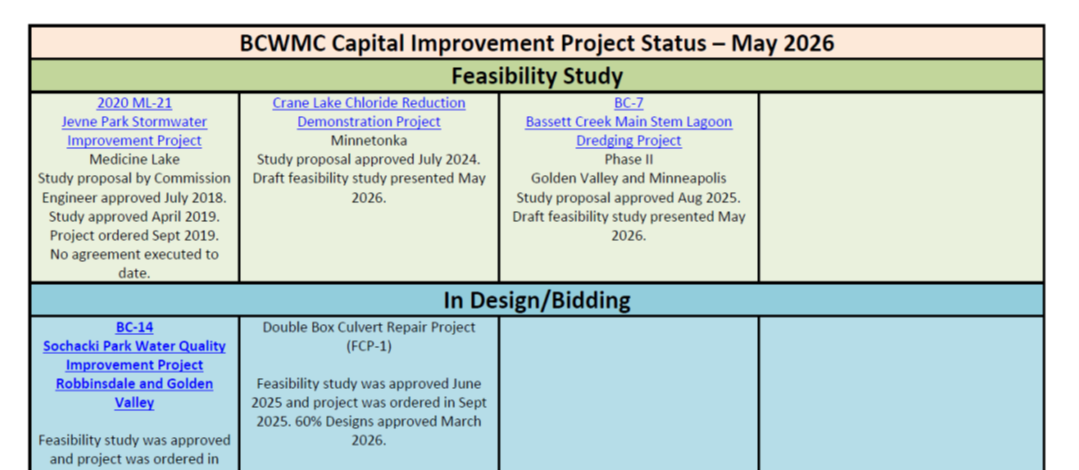

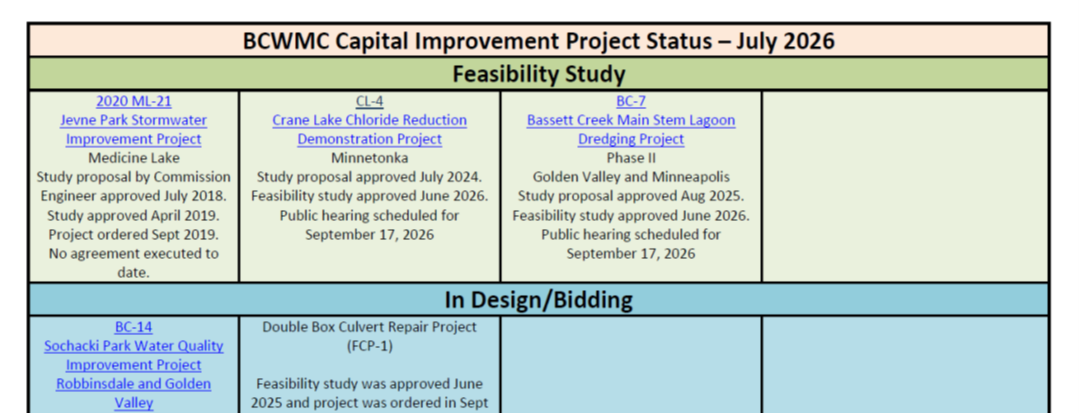

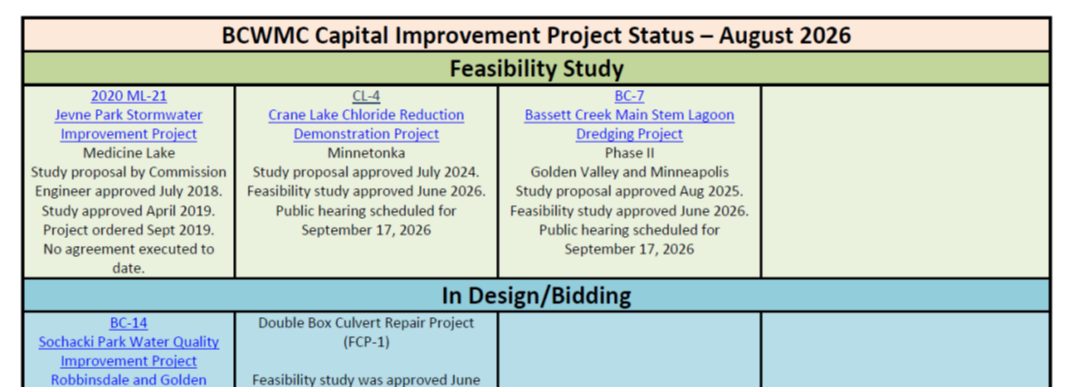

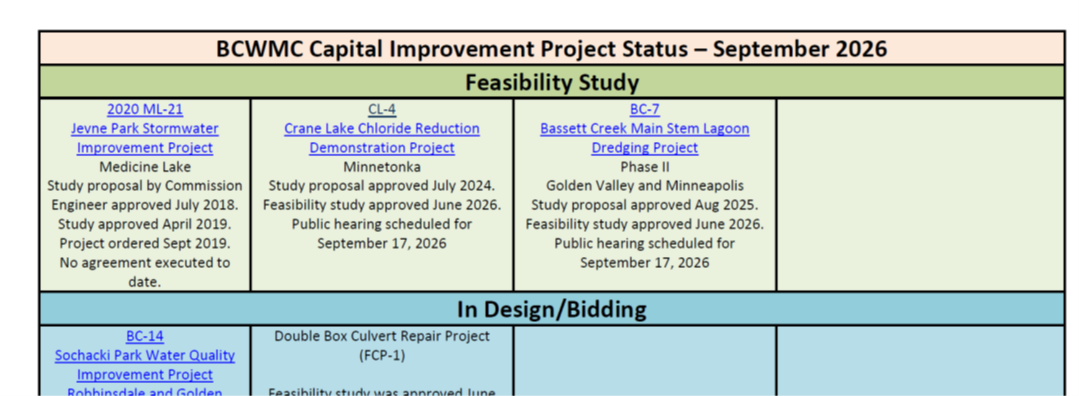

BCWMC Capital Improvement Program
2022 - 2026 CIP Table and Project Fact Sheets
2021-2025 CIP Table and Project Fact Sheets
2020 - 2024 CIP Table and Project Fact Sheets
BCWMC's CIP Process Flowchart and Timeline
CIP Prioritization Matrix | CIP Prioritization Maps
Fact Sheet: XP-SWMM Project & New Flood Elevations
XP-SWMM Phase II Final Report (August 2017)
Appendix A ‐ Comparison of BCWMC Historic Flood Profiles to the Phase 2 XPSWMM Model Results (August 2017)Phase 2 XPSWMM Model Results (August 2017)
XP-SWMM Phase II Project Overview Presentation (January 2017)
XP-SWMM Phase II Project Budget and Timeline (April 2015)
P8 Model Extents Map - Shows individual drainage areas included in each model. Can be viewed as key for nomenclature on other files.
Pond Performance Map - Shows overall results of prioritization process with high, medium and low priority ponds for entire watershed.
Pond Ranking Table - Spreadsheet with all pertinent P8 model results used to develop and rank/map prioritized ponds. Includes links of pond rankings to each city (in ‘MS4’ column) for sorting.
Following maps show results for each major drainage area in a color scale depicting where highest runoff TP concentrations are being delivered downstream. Red-shaded subwatersheds delivering flow to a receiving water represent highest priorities for future BMPs, while the green-shaded areas likely indicate good BMP treatment already exists.
Medicine Lake Direct | Medicine Lake NE | Medicine Lake North
Medicine Lake South | Northwood-Bassett Cr Park Pond
Parkers-East Parkers | Plymouth Creek | Sweeney-Twin Lake
